Beyond the Megawatts: Navigating India’s Land-Energy Paradox in the Race to 500 GW
When the Asian Development Bank (ADB) yanked its $434 million loan from a planned 1,000-megawatt solar plant in Assam’s Karbi Anglong district, the shockwaves travelled far beyond the local hills. This wasn’t a standard collapse triggered by bad math or bankruptcy. It was a watershed moment for the Indian grid. For the first time, a massive project died because it ignored the people on the ground. Twenty-four local villages stood their ground, arguing that the facility—slated for ancestral grazing lands and sacred groves—had steamrolled the principle of Free, Prior, and Informed Consent (FPIC).
The message is loud and clear: India’s sprint toward 500 GW of renewable energy by 2030 is no longer just an engineering marathon. It has morphed into a high-stakes brawl over land rights, ecological survival, and the soul of “green” progress.
The Friction Between Ambition and Ground Reality
India currently sits at 71st place on the World Economic Forum’s Energy Transition Index 2025. We are diversifying fast, but the Economic Survey recently flagged a “bottleneck trifecta” that could stall the whole engine: skyrocketing capital costs, grid instability, and—most dangerously—land acquisition delays.
The physics of the transition is land-hungry. You can’t tuck a utility-scale solar farm into a small corner like a coal plant. To balance the flickering nature of renewables, the Central Electricity Authority (CEA) says India needs 336 GWh of energy storage by 2029-30. This adds a new layer to the map: Pumped Hydro Storage (PHS), which often means flooding forests, and Battery Energy Storage Systems (BESS), which require precise, high-tier industrial zoning.
Mapping the Conflict: A Regional Breakdown
A “green” sticker doesn’t grant an automatic license to operate. From the desert to the jungle, local communities are pushing back against what some call “green grabbing.”
| Project / Region | Scale / Investment | Primary Conflict Factor | Status / Consequence |
|---|---|---|---|
| Karbi Anglong, Assam | 1,000 MW / $434M | Indigenous land rights & lack of FPIC | ADB Loan withdrawn; Project in limbo |
| Rajasthan (GIB Habitat) | 10,000 MW / ₹48,500 Cr | Ecological conservation vs. Solar infra | Stalled by Supreme Court litigation |
| Rajasthan (Orans) | Community Pastures | Threat to livestock-dependent livelihoods | Ongoing protests by herder collectives |
| Tirunelveli, Tamil Nadu | 150+ Acres | Alleged document forgery & coercive acquisition | Localized protests and ongoing legal scrutiny |
| Siang River, Arunachal | 11,500 MW (Hydro) | Cultural displacement & downstream risks | Massive indigenous resistance; security concerns |
| Pavagada, Karnataka | 2,050 MW | Land-leasing model (Success Case) | Operational; 2,300+ farmers receiving rent |
The “Waste Land” Myth and the Economic Cost of Delay
There is a persistent, dangerous habit in government circles of labeling community lands as “wastelands.” In Rajasthan, the Orans—ancient, community-protected pastures—are vital biodiversity hubs. To a bureaucrat, they look empty. To millions of herders, they are the only thing keeping their livestock alive. When the state reclassifies these as “unproductive” to make way for solar parks, it ignores centuries of customary rights.
The price of this spatial friction is staggering. The legal battle over the Great Indian Bustard (GIB) habitat in the Thar Desert has effectively frozen 10 GW of solar potential. Beyond the ₹48,500 crore in paralyzed investment, these delays create “stranded assets.”
Capital is locked in, but the turbines aren’t spinning. This drives up the “risk premium,” making it more expensive for everyone to borrow money for the next project.
Key Insight: The selection of “wastelands” often ignores the “invisible” economy of the rural poor. When energy needs for the urban grid collide with the survival of herders, the result is not just social unrest, but a quantifiable increase in the “risk premium” for international investors.
Regulatory Labyrinths and the Material-Spatial Nexus
Don’t let the “White Category” label fool you. Even if renewable projects get a pass on some environmental paperwork, they are still tethered to the LARR Act of 2013 (Land Acquisition, Rehabilitation, and Resettlement).
- The Consent Barrier: Private developers must get the green light from 80% of affected families. But in a country where land records are often a mess of outdated paper, even finding those families can take years.
- The Role of State Governments: Land is a “State Subject.” That’s why the transition looks different in every zip code. Karnataka’s “lease-hold” model lets farmers keep their land while getting paid, but other states still rely on “eminent domain,” which is almost a guarantee of a lawsuit.
- Beyond Land: Material Chokepoints: It’s not just about where the panels go, but what’s inside them. The Economic Survey warns that storage-heavy grids make India a hostage to the price swings of lithium, cobalt, and rare earth elements. We are trading a dependency on domestic land for a dependency on foreign minerals.
Recalibrating the Transition: The Way Forward
If we want to avoid a future of stalled projects and angry protests, the strategy has to shift. We need a “people-centric” blueprint.
- The “Pavagada Model” of Land Leasing: Stop buying land. Lease it. In Pavagada, farmers get annual rent with built-in raises. They keep their ancestral assets; the developers get their sun. Everyone wins.

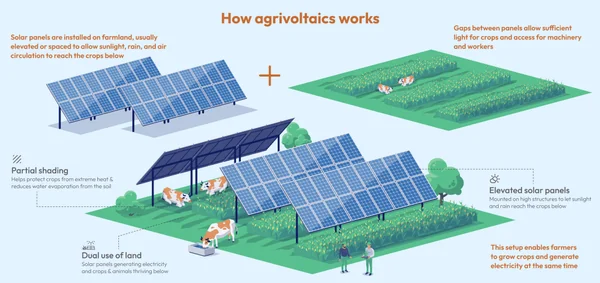

- Agrivoltaics and Co-beneficial Use: Why choose between food and fuel? By raising panels high enough to let crops grow underneath, India can solve the spatial squeeze. It keeps the farm productive while adding a second paycheck for the farmer.
- The India Energy Stack: We need a digital nervous system for energy by 2025. This means a platform that blends satellite maps, land titles, and ecological data to find “low-conflict zones”—like old mines or brownfield sites—before a single rupee is spent on a surveyor.
- Decentralized Energy Systems: We need to stop obsessing over massive, distant parks. Rooftop solar and micro-grids put power where it’s used, cutting down the need for long, controversial transmission lines that cut through sensitive habitats.
“A meaningful relationship and cultural connection are often the most overlooked aspects of energy projects, yet they are the most critical for community acceptance. If the people are not partners, the project is a liability.” — Quenten Agius, Chairperson, Ngadjuri Nation.
Summary of Key Findings
- “India’s 500 GW target faces a ‘spatial crisis,’ with ₹48,500 crore in solar assets stalled by ecological and community litigation over land rights.”
- “The ADB’s exit in Assam proves that social license is now as vital to project survival as financial backing or engineering.”
- “Success requires a just transition using land-leasing, agrivoltaics, and the ‘India Energy Stack’ to balance national power with local livelihoods.”
