The Cost of Headwinds: How Europe’s Turbine Squeeze and Geopolitical Pincers Impact India’s 37 GW Offshore Wind Ambitions
The year 2026 has shown that the global pivot to marine wind energy is choking on structural supply bottlenecks. While India’s vast 7,600-kilometre coastline holds immense theoretical potential for offshore wind, the international economic and geopolitical climate has turned sharply hostile for developing nations trying to extract value from their blue economies.
For New Delhi—which hopes to auction 37 GW of offshore wind capacity by 2029–30—a double whammy of global price shocks and domestic red tape threatens to derail its maritime energy timeline before the first turbine even spins.
The Onshore Transition and Offshore Economics
India’s broader green blueprint calls for 140 GW of total wind capacity by 2030, with offshore wind slated to chip in 30 GW. Hit that target, and the country must erect 7.5 GW of new wind towers every single year. But look at the onshore reality. Ever since the government rolled out its reverse auction regime back in 2017—a policy it finally ditched in January 2023—onshore growth has been in a tailspin. Prime Tier-1 and Tier-2 sites are gone. Land acquisitions are a bureaucratic nightmare. State-level distribution companies (discoms) are notorious for payment delays. Consequently, India dragged its feet to add a paltry 8 GW of wind capacity over a five-year stretch, spectacularly missing its 2022 milestone of 60 GW.
Deep-water wind looks like the silver bullet. It boasts a far superior Capacity Utilisation Factor (CUF), sidesteps messy land disputes, and pumps out dependable Round-the-Clock (RTC) green electrons to power heavy industrial belts in Tamil Nadu and Gujarat. The catch? The price tag is staggering.
Generation Technology Comparison in India (July 2026)
| Technology | Capital Cost (per MW) | Capacity Utilization Factor (CUF) | Status / Commercial Readiness |
|---|---|---|---|
| Solar PV | Rs. 47.1 Million | ~19% – 25% | Mature / Highly Scaled |
| Onshore Wind | Rs. 64.9 Million | 30% – 40% | Mature / Land-Constrained |
| Offshore Wind (Fixed-Bottom) | Rs. 207.5 Million | 50% – 55% | Pre-commercial / Supply-Chain Dependent |
| Floating Offshore Wind | Rs. 450+ Million (Est.) | 55% – 60% | Pilot Stage (Gulf of Mannar Feasibility) |
Yes, building a fixed-bottom offshore project demands over three times the capital of an onshore setup per megawatt. But that 50–55% CUF changes the math. Over a project’s operational life, the cost per unit becomes highly competitive—assuming India can localise its supply chain and scale up its domestic transmission network.
The European Duopoly and the Geopolitical Pincer

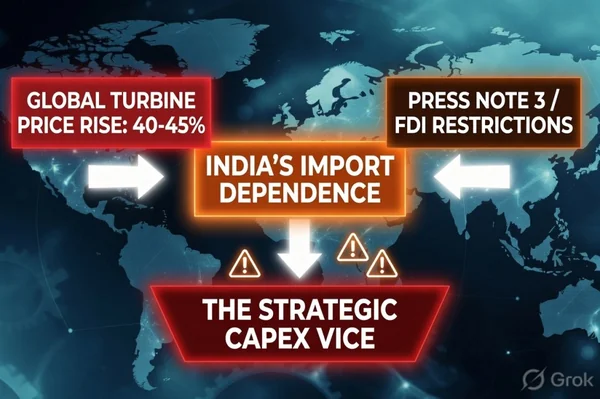

For years, three giants controlled the Western marine wind market: Siemens Gamesa, Vestas, and GE Vernova. That club has shrunk. With GE Vernova freezing new offshore orders to lick its wounds from operational and technical setbacks, the market has consolidated into a tight duopoly run by Siemens Gamesa and Vestas. This concentration of market power has broken the industry’s economic model. Turbine price tags have skyrocketed by 40% to 45% since 2020, far outstripping the 20% to 25% rise in actual factory floor costs.
This leaves pioneering markets like India in a bind. Lacking a domestic manufacturing base for marine wind, developers have no choice but to import heavily marked-up European hardware.
Geopolitics makes this squeeze even tighter. Chinese turbine manufacturers like Mingyang and Goldwind offer a much cheaper lifeline, but New Delhi’s strict security vetting and import barriers on land-border-sharing countries under Press Note 3 block that exit route. Indian developers are stuck with expensive European suppliers. It is a strategic pincer movement that drives up capital expenditure and threatens to suffocate early-stage projects.
Eleven Years of Promises: India’s Policy Push and the 37 GW Roadmap
To get things moving, the Ministry of New and Renewable Energy (MNRE) mapped out an ambitious blueprint in its 2022 strategy paper. The goal: auction 37 GW of offshore leases by 2029–30, starting with 4 GW annually from 2022 to 2025, scaling up to 5 GW annually from 2025 to 2030.
To grease the wheels, New Delhi rolled out several policy sweeteners:
- April 2026: The government launched targeted subsidies for specialized installation vessels and undersea cable-laying operations.
- May 2026: Officials extended the waiver on additional surcharges for marine wind projects.
Yet, the industry is losing patience. It has been eleven years since the National Offshore Wind Energy Policy was first gazetted on October 6, 2015, and four years since the 2022 roadmap was published. Despite the hype, the final seabed leasing rules are still stuck in bureaucratic limbo. Given that offshore wind installations take seven to eight years from blueprint to execution, the odds of seeing commercial power flow before 2030 are vanishingly slim. The grand strategy risks looking like a paper exercise.
Navigating Grid Evacuation, Port Readiness, and Tender Delays
India’s offshore rollout rests on a three-pronged framework:
- Model 1: Government-backed sites where MNRE and the National Institute of Wind Energy (NIWE) run initial studies, sweetened with Viability Gap Funding (VGF).
- Model 2: Developer-led surveys in NIWE-demarcated zones, with companies vying for central fiscal support.
- Model 3: Exclusive lease concessions where developers take on all the heavy lifting—surveys, clearances, and securing power purchase agreements.
In all three models, the original policy assigned a critical job to the Central Transmission Utility (CTU): building the power lines from the offshore pooling stations to the mainland grid. But that plan has run aground.
The Transmission Cost Shift and the LCOE Gap
The latest draft Request for Selection (RfS) pulled a fast one on developers, dumping the cost of building offshore substations and subsea cables onto their balance sheets. The Global Wind Energy Council (GWEC) has sounded the alarm: forcing developers to absorb these massive subsea evacuation costs will inflate tariffs. To keep power prices competitive, transmission costs must be separated from the core Levelized Cost of Electricity (LCOE).
The numbers reveal a massive disconnect. While the Tamil Nadu government wants to cap tariffs at Rs. 4 per kWh for Model 2 and 3 projects, the actual LCOE for India’s maiden 1 GW project in Gujarat (Model 1) is projected to sit between Rs. 7 and Rs. 9 per kWh. That is a gaping chasm between political wishful thinking and commercial reality.
The Tamil Nadu Tender Deadlock
By July 2026, negotiations between the central ministry and the Tamil Nadu government over these “Model 3” transmission costs have hit a brick wall. This standoff has indefinitely stalled the seabed auction of four key blocks off the Tamil Nadu coast—a tender originally slated for March.
Port Infrastructure Bottlenecks
Port readiness is another major headache. Marine wind turbines are behemoths. Ports like V.O. Chidambaranar Port (Tuticorin) in Tamil Nadu, along with Adani’s Mundra and Kandla hubs in Gujarat, simply cannot handle 15 MW nacelles and 120-metre blades in their current state. Without heavy-load quaysides, specialized storage yards, and berths capable of hosting 1,500-tonne crawler cranes, India’s offshore dreams remain stuck on land.

De-Risking the Horizon and Building Local Supply Chains
To break the grip of high European import costs and geopolitical bottlenecks, India must build its own manufacturing ecosystem and upgrade its maritime infrastructure.
- Fiscal Incentives: Developers are lobbying hard for a 10-year tax holiday, alongside waivers on import duties and GST, to give the local supply chain room to grow.
- Scaling Up Turbine Manufacturing: Indian factories can build onshore turbines up to 3.6 MW, but building the 15 MW giants needed for deep-water installations is a completely different ballgame. Industry voices are demanding that the government fast-track the long-delayed Production-Linked Incentive (PLI) scheme, as local 15 MW prototype development has ground to a halt.
- Addressing Resource Gaps: We are still flying blind in some areas. Tamil Nadu’s offshore zones lack comprehensive Light Detection and Ranging (LiDAR) wind data. Without high-quality site surveys, engineering foundations that can survive violent tropical cyclones is guesswork.
- International Collaboration: Financing early-stage 6-to-10 MW demonstration turbines in Gujarat and Tamil Nadu will require backing from multilateral development banks (MDBs) and global bodies like the Global Offshore Wind Alliance (GOWA) to absorb early-stage risks.
- Environmental Safeguards: Projects must clear strict regulatory hurdles, including the CRZ Notification 2019, EIA Notification 2006, and international shipping and fishing exclusion zones. Thorough Environmental Impact Assessments (EIAs) are indispensable to ensure these projects do not ruin local marine ecosystems.
Summary
- Supply Pincer: Expensive European turbine duopolies and barriers on cheaper Chinese imports squeeze project margins.
- Grid & Port Bottlenecks: Unresolved transmission cost disputes and inadequate deep-water port infrastructure stall critical tenders.
- Policy Inertia: Eleven years post-policy, India must fast-track localized manufacturing and subsidies to bridge the LCOE gap.
